Project Cost Forecast

Acumatica, Writeback

The Project Cost Forecast Writeback template revises project budget quantities, amounts, and completion percentages in Acumatica directly from a workbook. You can use the template for estimate to complete updates on construction projects, revised task budgets, project cost reforecasts, and ongoing tracking of the percentage complete. It uses the NECWRITEBACK formula, generated with the Writeback Wizard, to send changes from your workbook back to Acumatica.

Prerequisites in Acumatica

Enable Change Order Workflow for the project in Acumatica before you update revised quantities or revised amounts.

Write a project cost forecast back to Acumatica​

  1. Select the Project and review the project header fields.
  2. Click Initialize to create a copy with static data.
  3. Update the green columns in the project cost grid.
  4. Review the project, then click Push to Acumatica.
  5. Click Reset before you start another project cost forecast.
Project Cost Forecast Writeback template in a workbook, showing the project header with the financial summary, the writeback action buttons, and the project cost grid

Project header fields​

The project header identifies the project and its key information. When you select a Project, the template loads the other header fields and the budget lines of that project.

Header fieldWhat it contains
ProjectProject whose budget lines will be reviewed and updated.
TypeProject type associated with the selected project.
DescriptionDescription of the selected project.
Start DateProject start date.
End DateProject end date.
CurrencyCurrency used by the project.
IncomeTotal project income.
ExpenseTotal project expense.
Margin %Project margin percentage based on the displayed income and expense values.

Writeback actions​

Writeback actionWhat it does
InitializeCreates a separate workbook copy with (Initialized) added to the file name. Extracted data is made static in this copy so it remains available while forecast values are entered.
Push to AcumaticaValidates and writes the revised quantities, revised amounts, and completion percentages to the selected project in Acumatica.
ResetClears the current changes and restores the workbook to its last saved state. Any unsaved entries or edits are removed.

Project cost grid​

The project cost grid lists the budget lines of the project by task, account group, and inventory item. You can edit only the green columns, Revised Quantity, Revised Amount, and % Complete, which the template writes back to Acumatica.

Project cost columnWhat it contains
Task IDProject task associated with the budget line.
Task DescriptionDescription of the project task.
Account GroupAccount group assigned to the budget line.
Inventory IDInventory item associated with the budget line, when applicable.
Original QuantityOriginal budgeted quantity.
Original AmountOriginal budgeted amount.
Revised QuantityUpdated budget quantity to write back to Acumatica.
Revised AmountUpdated budget amount to write back to Acumatica.
Actual QuantityActual quantity recorded against the budget line.
Actual AmountActual amount recorded against the budget line.
Variance $Difference between the revised budget and actual amount.
% CompleteEstimated completion percentage for the budget line.

Review the project before writeback​

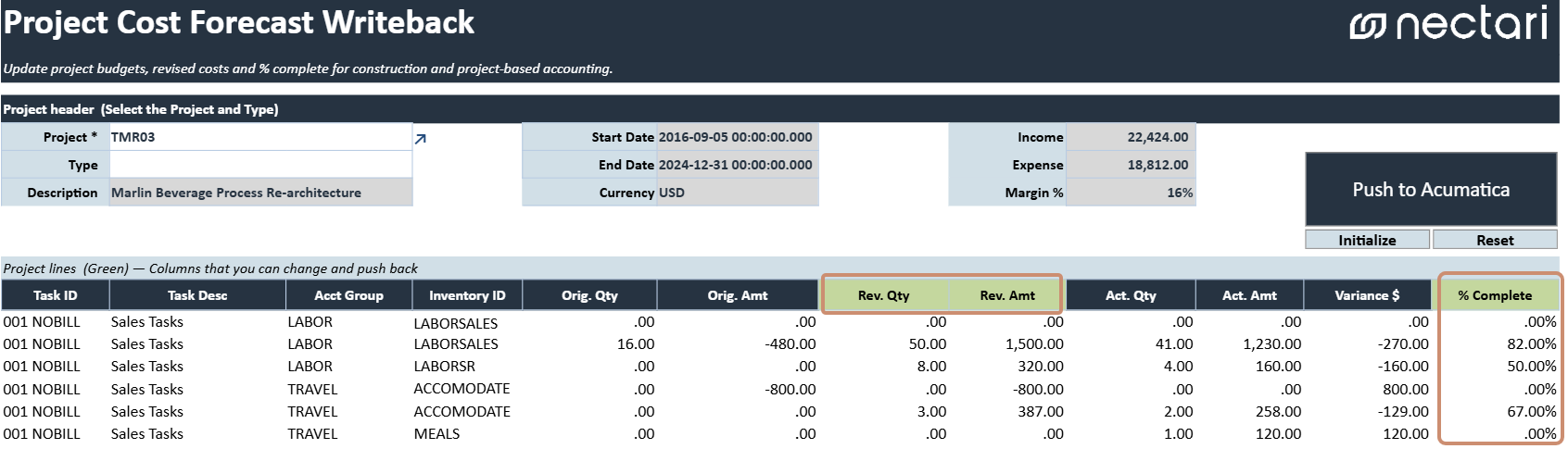

Project Cost Forecast Writeback template, showing the project header summary and the revised quantities, revised amounts, variances, and completion percentages in the project cost grid
  • Confirm that the correct Project is selected.
  • Review the project dates, currency, income, expense, and margin.
  • Compare the Revised Quantities and Revised Amounts with the latest estimate.
  • Confirm that the completion percentages are consistent with project progress.

Enable the change order workflow for a project in Acumatica​

  1. Log in to Acumatica.
  2. In the main menu, select Projects. If you don't see it, click More Items.
  3. Under Profiles, click Projects.
  4. Select the project in the list, then click the pencil icon.
  5. On the Summary tab, select the Change Order Workflow checkbox.
  6. Click Save.

Summary tab of a project in Acumatica, with the Change Order Workflow checkbox highlighted
